Factory Setup

Precast Factory Layout Guide

Layout principles for casting halls, reinforcement, curing, storage, traffic and future expansion.

layoutfactory setupcrane
Precast Factory Layout Guide reference

Technical summary

A good layout shortens handling distance, reduces waiting time and prevents storage from becoming the hidden bottleneck.

Field notes

Precast Factory Layout Guide operating variables

A good layout shortens handling distance, reduces waiting time and prevents storage from becoming the hidden bottleneck.

Parameters to verify

  • Map material flow from raw material arrival to finished product shipment.
  • Locate cranes around real lifting paths.
  • Reserve space for curing and repairs.
  • Plan traffic so trucks do not block production.

Records and inputs

  • Land survey
  • Product mix
  • Element weights
  • Storage days

Failure modes to watch

  • No safe lifting route.
  • Storage too small.
  • Maintenance areas missing.

Visual workflow

Factory flow, not a machine list

Generated workflow composite for explaining factory zones. It is not a supplier photo; use it to read the process sequence and interface points.

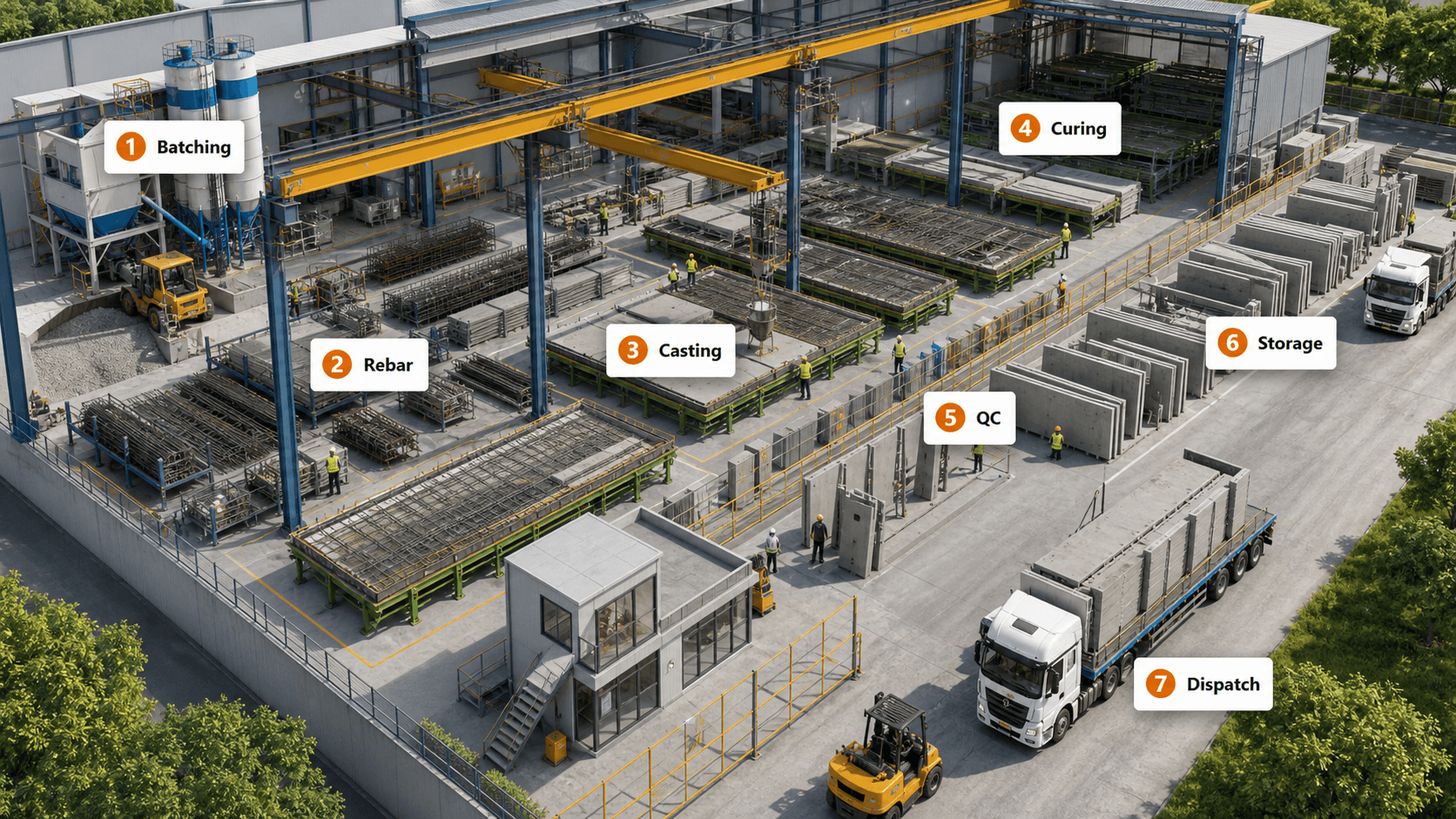

Generated visual showing a precast factory layout with batching, rebar, casting, curing, QC, storage and dispatch zones
1Batching

Concrete supply position affects travel distance, distributor route, mixer backup and washout planning.

2Rebar

Cage and mesh preparation must feed molds before casting; late reinforcement becomes the hidden bottleneck.

3Casting

Tables, molds, embedded parts, concrete delivery and vibration decide the real cycle, not a single machine speed.

4Curing

Curing area and temperature control set demolding rhythm and early-strength reliability.

5QC

Inspection needs space, lighting, measuring tools and records before elements enter storage.

6Storage

Rack layout, support points, repair access and truck loading sequence determine damage risk.

7Dispatch

Finished-element logistics links yard planning, road access, delivery batches and site unloading method.

Production context

A good layout shortens handling distance, reduces waiting time and prevents storage from becoming the hidden bottleneck.

Where this applies

  • layout planning and comparison
  • factory setup planning and comparison
  • crane planning and comparison

Engineering variables

  • Map material flow from raw material arrival to finished product shipment.
  • Locate cranes around real lifting paths.
  • Reserve space for curing and repairs.
  • Plan traffic so trucks do not block production.

System interfaces

  1. Compare layouts using travel distance and crane conflicts.
  2. Ask suppliers where bottlenecks usually appear.
  3. Check expansion paths early.

Production evidence checklist

Production variableWhy it matters in productionRecords or evidence to inspectInterface risk
Land drawingSets building span, casting hall length, crane runway, yard reserve, truck turning radius and future expansion edge.Dimensioned plot plan, existing buildings, road access, power/water points, drainage and height restrictions.A line concept can look efficient on paper while storage, truck access or crane coverage fails on site.
Target productsDrives mold type, casting orientation, reinforcement workflow, curing method, lifting points and storage racks.Product family list with dimensions, weight range, reinforcement level, finish requirement and project drawings.Wall panels, hollow core slabs, pipes, piles and poles create different factories; mixing them without phases causes layout conflict.
Daily outputConverts sales target into tables, molds, beds, curing slots, crane cycles, labor stations and yard occupancy.Pieces/day or m2/day by product, shift hours, demolding age, expected rejection/repair allowance and delivery batches.Nominal machine capacity is meaningless if curing, demolding, QC or storage cannot release elements at the same rhythm.
Utility availabilityConstrains batching, steam or hot-water curing, air tools, welding, cranes, compressors, pumps and lab equipment.Power capacity, voltage, water supply, boiler/steam plan, compressed air, wastewater route and backup assumptions.Underpowered utilities turn commissioning into local construction work rather than production startup.
Labor assumptionsDefines automation level, table count, rebar preparation method, QC staffing, maintenance coverage and training load.Shift pattern, operator skill level, maintenance team, welding/rebar crew availability and supervision structure.High automation still needs disciplined maintenance and data entry; manual plants still need enough skilled station leaders.
Local standardsControls concrete class, tolerances, testing frequency, reinforcement detailing, lifting rules and project approval documents.Project specification, applicable code, client approval checklist, required certificates and inspection hold points.A factory can physically produce an element that still cannot pass local project approval.

Technical references

Original sources and related manuals

Open the governing standard record, original process source or related product manual for the underlying scope and terminology.

VollertPallet and transport technology reference

Use the machine groups and station names to read how pallet movement, turning, storage and plant control connect.

Open process reference
Weiler GmbHPrecast plant, batching and concrete transport systems

Use the manufacturer overview to connect batching, mixer, concrete delivery, casting beds and plant-handling interfaces.

Open process reference
Apollo Afinitas TechnologiesConcrete pipe, manhole and box-culvert plant equipment

Use the official overview for infrastructure product lines, molds, cage welding, curing and handling equipment scope.

Open process reference
H-LiftGrade 80 precast lifting clutch

Manufacturer product reference for clutch geometry, lifting interface and handling-system compatibility.

Open process reference

Weak assumptions seen in projects

  • Making the casting hall efficient while the yard fails.
  • Forgetting reinforcement staging.
  • Using maximum product size as the only layout basis.

Inspection and acceptance points

  • No safe lifting route.
  • Storage too small.
  • Maintenance areas missing.
  • Truck movement conflicts with workers.

FAQ

What is the first decision to make for precast factory layout guide?

Start with product type, target capacity and local requirements. These inputs shape equipment, mold, material and quality-control choices.

What information should be prepared before speaking with suppliers?

Prepare drawings, target output, local standards, installation limits, available utilities, budget range and the questions you need answered.
